Inside UK's 'most complicated' bridge demolition

Jason Arunn MurugesuNorth East and Cumbria

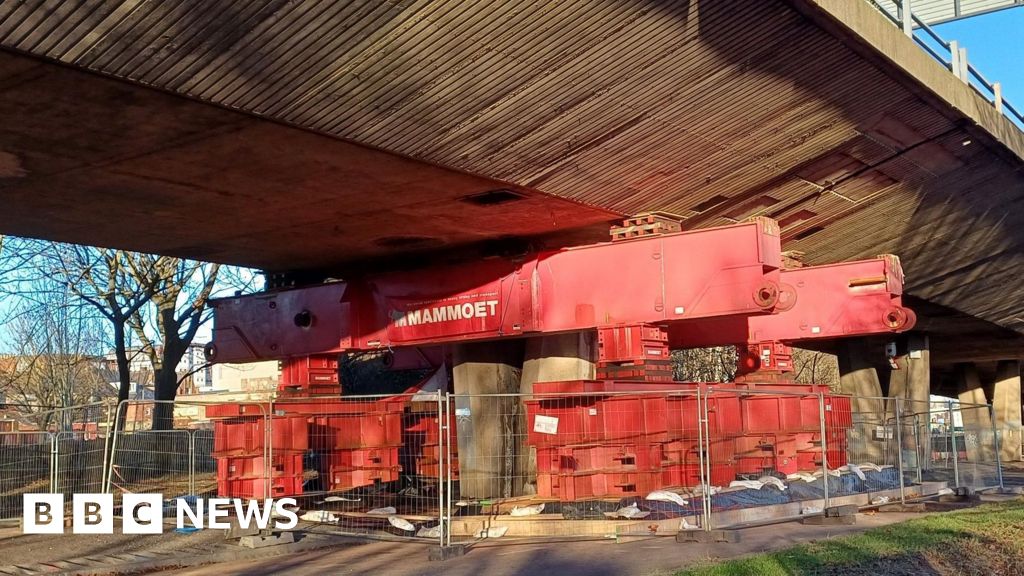

BBC A temporary prop underneath the Gateshead Flyover. It is a huge red metal structure and is fenced off. The flyover above is made from concrete.BBC
The demolition is expected to take about six months

It has been nearly 500 days since the sudden closure of the Gateshead Highway flyover, prompted by "serious concerns" about the possibility it might collapse. This week, the structure's demolition finally begins in earnest.

But what does it take to knock down a bridge that goes over two large roundabouts and lies next to shops, blocks of flats and a school? Not to mention the fact it runs above tunnels through which the Tyne and Wear Metro runs.

"It's probably the most complicated demolition project going on in the country at the minute," says one of the people leading the project, Jim Smyth, from construction company Bam.

Here is what is known so far about the demolition, how it may affect your commute, and what consequences there may be for those living or working nearby.

At the end of 2024, the 0.6 mile (0.95km) A167 flyover was carrying about 40,000 vehicles a day

But the 1960s post-tensioned structure was closed on 13 December that year after inspectors flagged serious concerns about one of its supporting pillars. It was subsequently revealed the flyover had major issues with drainage and there was water seeping through it.

The demolition, approved last year, was estimated to take six months and be complete in October.

Gateshead Council The underside of the Gateshead Flyover. It is a concrete structure propped up by several pillars. There are trees growing to the side and a road runs underneath the structure.Gateshead Council
The flyover was deemed unsafe in 2024 and has been closed since

The first stage in any demolition is figuring out which method to use. Blowing the flyover up was one of many options considered by Smyth and his team. But this "just wasn't feasible", he says, given its proximity to other buildings, roads and the Metro.

Another problem with this method was the need to "pre-weaken" the structure first, to ensure it collapsed in a controlled way.

"Everyone lost their appetite when you thought - oh, you've got to pre-weaken a weak bridge," Smyth says.

Jim Smyth wearing a black jacket which says "bam" in green lettering on the left breast pocket. He has grey stubble and is smiling at the camera. Behind him is a car park and a fencing and a large green machine. You can see the doomed flyover in the background being propped up.
Jim Smyth said the demolition was currently one of the UK's most complicated

Eventually the team decided they would break down the flyover mechanically, piece by piece, using machines colloquially known as munchers.

These claw-wielding cranes will methodically crunch and pulverise the concrete.

Estimated to cost up to £18m, the demolition will be split into three main phases: the destruction of the central section, then the sections above the two roundabouts and, lastly, the part which lies directly above the Metro tunnels.

But, to do this, the team had to consider two of the bridge's main design features.

The first is the fact the bridge is constructed like a seesaw in that it is balanced in the middle. This means one side cannot be demolished without the other side becoming unbalanced and tipping over.

"We have to work from either side at the same time," Smyth says, comparing the action to using a typewriter.

Gateshead Council The arm of a crane with pincer-like claw is biting at a building to bring it down. There are cars parked beyond and fencing round the area being demolished. The crane says Thompsons. The building is half destroyed.Gateshead Council
So-called munchers were used to demolish Computer House, a building near the flyover

The team's other key consideration is the post-tensioned steel cables which run throughout the flyover to reinforce it. Once covered in concrete, these are pulled and anchored so demolishing one part of the structure could affect the tension in cables in another section, causing it to collapse.

To account for this, the team will use steel props to support one part of the bridge while another is being destroyed. These props will move along the flyover in tandem with the demolition.

A man in orange hi-vis overalls and white hard-hat stands on a road under a concrete road bridge near traffic cones and yellow demolition equipment. Other, similarly dressed, workers are in the distance. The bridge feels like a long, low, concrete roof.
The bridge is balanced on piers in the middle

Gateshead Council is yet to say exactly how traffic will be affected during the six-month project. It is still finalising its plans with major routes unlikely to be affected until later this summer, it says.

Nevertheless key roads, and Park Lane and Bellevue roundabouts,are expected to be shut for multiple weeks and some bus routes and footpaths have already been diverted.

A scaffold screen has been put up to protect nearby office building Aidan House from debris but the local authority has not said what plans it has for a nearby blocks of flats.

Gateshead Council Overhead satellite map of Gateshead flyover which is colour coded into three main sections: left hand yellow section, middle blue section and right hand red section. There are dotted lines showing the Metro tunnels underneath the blue section.Gateshead Council
The flyover's demolition will be split into multiple sections

Some 24-hour working during the project is expected, says Smyth. This could include breaking down the bridge during the day and then loading and removing rubble overnight.

The council says it expects Metro trains to continue running through the tunnels underneath the demolition.

The team has put sensors in the rail tunnels so they will be alerted if the demolition causes even miniscule shifts in the structures.

Gateshead flyover is fenced off and propped up by dozens of steel props. In front of the fencing is a green machine and a blue fork-lift type machine. They are all on dirt ground and lots of industrial parts lie on the ground.
The bridge is being propped up during the demolition

Smyth says the project has generated interest from engineers across the country.

"There's not a bridge of this size, of this design, which has been demolished before that we're aware of," he says.

But there are multiple similarly designed bridges all around the UK, built about the same time as the Gateshead flyover, so he does not believe this will be the last demolition.

"Concrete only has a given lifespan," he says.

"There will be plenty more."
